Latest Updates
Latest News
See all news
Progress on piling and temporary terminal works
October 8, 2026
First pile casing pitched
September 15, 2026
On 3 November, our Ferry Infrastructure Project Team reached another significant milestone - the first concrete pour and the completion of the first permanent pile.
The pour involved over 100m3 of reinforced concrete, poured into a hopper above the steel pile casing. Around 25 concrete trucks were involved in this pour.
Update 2 November 2026
Representatives from the consenting teams at Wellington City Council (WCC) and Greater Wellington Regional Council (GWRC) visited the Ferry Infrastructure Project site at Kaiwharawhara last week, seeing first-hand the scale and progress of the work they are helping to enable through the consenting process.
During the visit, the group toured key areas of the project site, gaining a valuable perspective on the significant progress made to date and the complexity of the marine infrastructure being delivered.
The tour also highlighted the project's environmental management programme. Visitors were able to view an active kororā (little penguin) burrow that is currently protected by a noise shroud, with a nesting penguin and two eggs inside. The project team explained the measures in place to protect marine wildlife and minimise disruption while construction activities continue. Protecting the harbour environment, including kororā and marine mammals, remains a key focus throughout the project.
The scale of the construction programme was evident across the site, particularly the specialised equipment being used for the significant piling programme for the project. Piling is a critical component of the marine infrastructure programme, with more than 50 permanent piles required across the project.
The Ferry Infrastructure Project requires a range of resource consents and approvals covering activities such as marine structures, earthworks, and spoil management. These approvals help ensure the project is delivered responsibly while balancing environmental, community, and operational considerations.
You can view our current consents and approvals on our Key Documents page.
Top of mind for the team in November is concrete - concrete for the first permanent pile and for laying the slab for the temporary terminal building Interislander staff will relocate into next year.
Update 15 September 2026

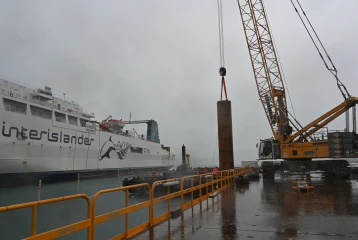

The Ferry Infrastructure Project celebrated a significant milestone at CentrePort last week, when the first permanent 24m-long pile was lowered into place by crawler crane.

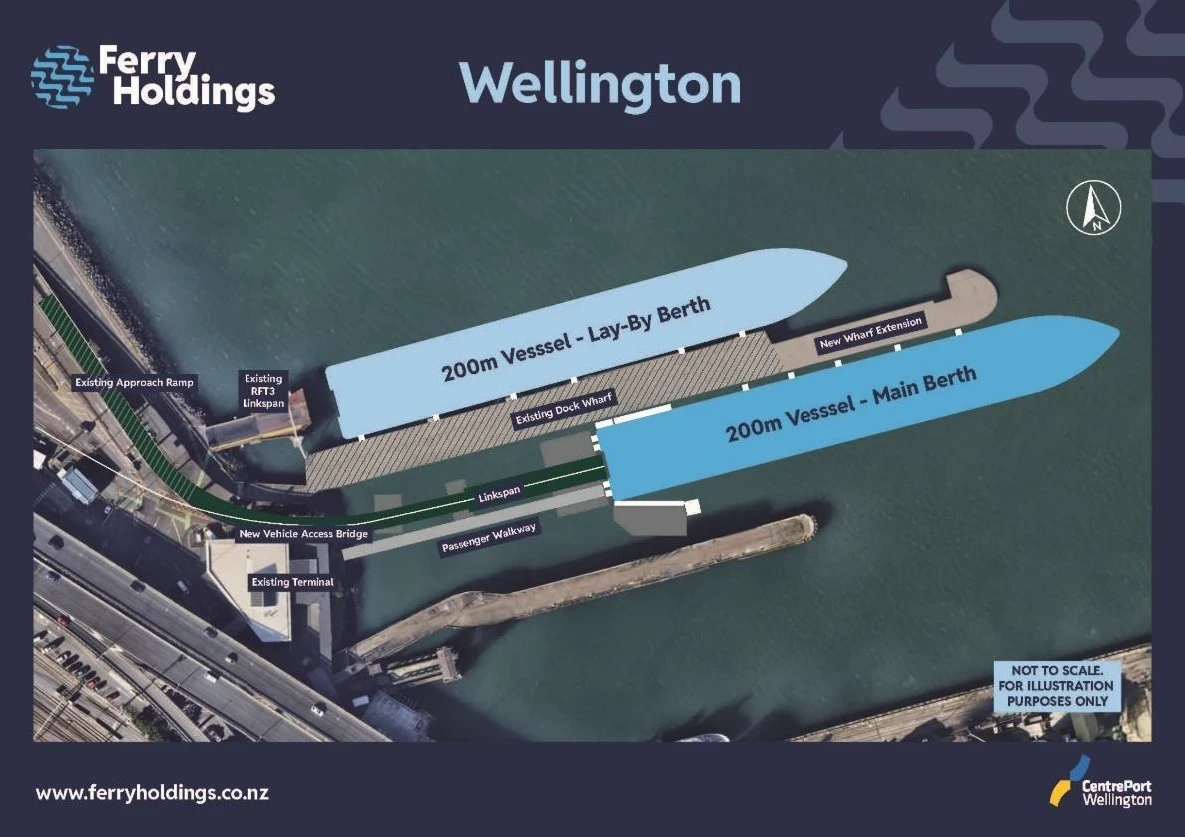

This marks the start of permanent works to enable the extension of Dock Wharf, which is required for the Cook Strait Interislander Ferry Replacement Programme.
18 permanent piles, 1.8m in diameter, are required for the Dock Wharf extension, and more than 50 permanent piles will be installed across the wider project, alongside the piles already in place to support our staging wharves.
Update 24 August 2026

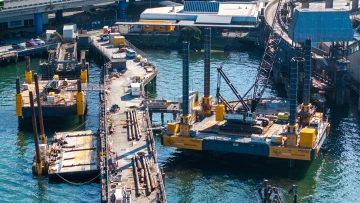

Our work to install a temporary staging wharf parallel to Dock Wharf is progressing well with 28 piles now in place for this structure. The staging wharf is an important piece of our project as it will be used to enable construction of Dock Wharf's extension. In particular, crawler cranes will sit on the wharf so they have access to where the permanent piles will be installed.

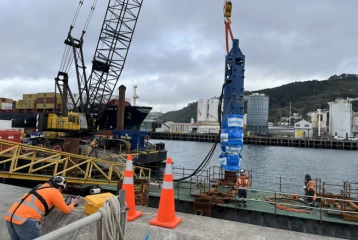

Permanent piling is scheduled to start in mid-to-late September at the end of Dock Wharf with 1.8m wide steel casings to be driven into the seabed. The casings will eventually be filled with concrete after being prepared and a reinforcing cage being lowered into the empty casing.
Eighteen piles are needed for the Dock Wharf extension structure. Other piles are needed for a further side nesting structure, which will be done using a barge with a crawler crane on top.
You may have seen the steel pile casings neatly stacked for and stored at Kaiwharawhara Point, having been ordered earlier from overseas. This ensured they would be available when we were ready to start piling work, although more are required.
When piling work begins at Dock Wharf, another piling crew will start working on the permanent piling for the Side Nesting Structure. This work will all be done with a crawler crane on a barge. These piles are also 1.8m wide in diameter, like those for Dock Wharf.
Elsewhere on the project, we've been installing new utilities for a temporary terminal building and continuing to remove the old linkspan structure. Both pieces of work should be completed next month.
Update 30 July 2026
Things are gaining momentum at the Kaiwharawhara site with piling for a staging wharf well and truly underway. Some people may have noticed the piling sound and for anyone who's reached out to us, we're keeping an eye (or should that be ear) to the issue with our Acoustic Consultants checking on sound levels.
The team is also starting to have more engagement with the community and key stakeholders to raise awareness about the ferry infrastructure work that CentrePort will deliver. The most recent was a meeting with the Wellington Residents Association Network this week, giving them a presentation on the project. You can access a copy of the presentation given to the group from our Key Documents page.
Consent applications we've submitted to council are beginning to come through, including ones required to set up a temporary terminal for the Interislander. The temporary terminal is needed for safety purposes and to ensure the ongoing operational efficiency of the ferry marine infrastructure works. We'll keep you informed of the details regarding the temporary terminal as it progresses.
Update - July 2026
This 3D video highlights the key upcoming works happening at Kaiwharawhara and the expected final infrastructure designs.
Update - June 2026
Work is gaining more momentum with materials arriving and set to be stored at the staging wharf area at what CentrePort calls 'South Road'.
These materials have long lead times between order and arrival, so while we're not ready to use some of it, we'd rather have it here for when we need it most!

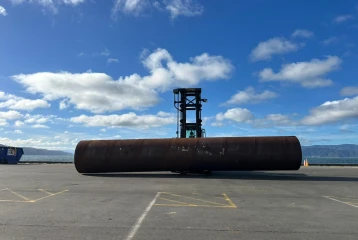

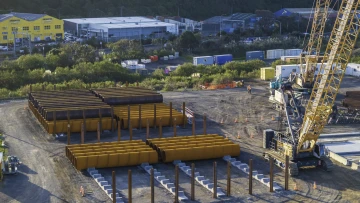

These are the casings for the major piles for our wharf extension and they're not your typical house piles. These are up to 2m in diameter - basically the height of basketballer Steven Adams.
We also see the start of piling work for another staging wharf at the Interislander site. This is something that people may hear. Noise will be monitored and generally only happen during the day.
View our prior media releases:
Latest photos

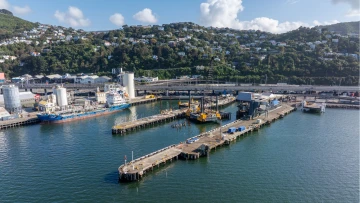

Interislander aerial view - April 2026
Old piles yet to be removed - April 2026

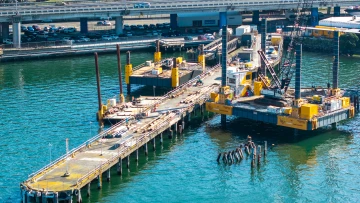

Interislander wharf - April 2026
Interislander aerial - April 2026

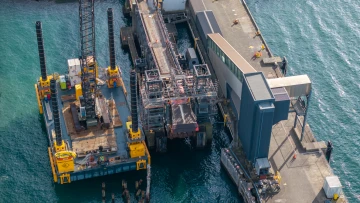

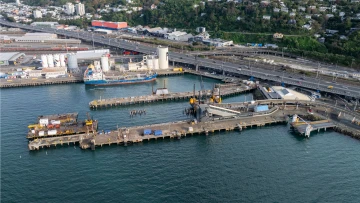

Interisland Wharf demolition of old structures - June 2026
Interisland Wharf aerial - June 2026

South Road removed piles - June 2026
South Road staging wharf - June 2026

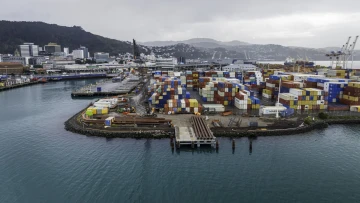

Southgate Staging area 26 July
Southgate aerial 26 July

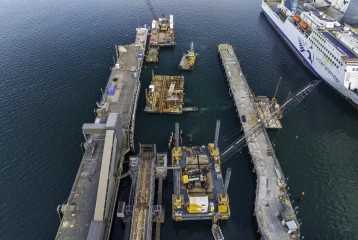

Interisland Wharf 23 July 2026
